Setting duration as 1 calendar day in project for the web and not working project creation

Ondrej Smreček 0 Reputation points
2024-04-02T10:22:22.8033333+00:00

Hi, i have project in project for the web.

Last 2 days im trying all combinations to set task duration equal to 1 calendar day.

Example of the desired behaviour:

Task starts on 10 April (including).

The duration of the task is 20 days.

The task should end on 29 April (by the end of the day).

The dependent task will start on 30 April.

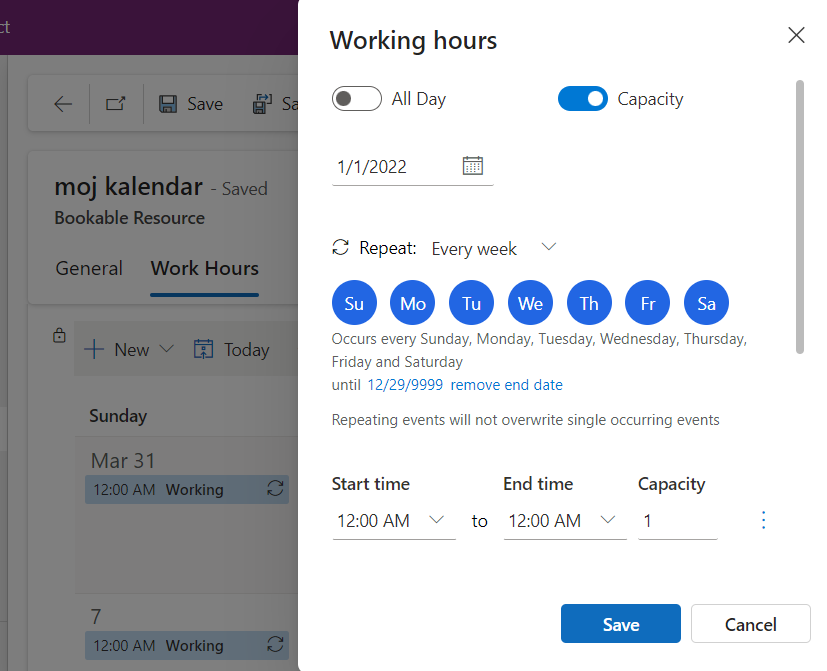

Working days are 7 days a week, all year round.

Actual behaviour:

If I enter a duration of 9 or 10 days, the finish date of the task is the same for both values.

A dependent task starts on the same day as the end of the previous task.

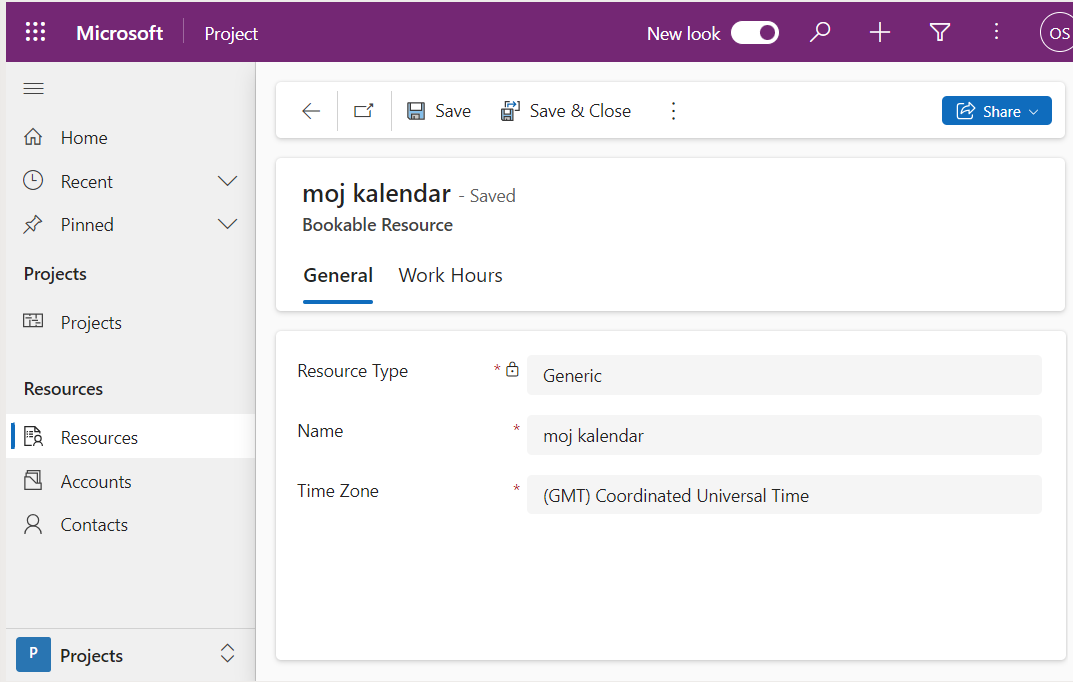

In the attachment I attach the ridiculous start and end of the task according to the set duration and calendar settings in power apps.

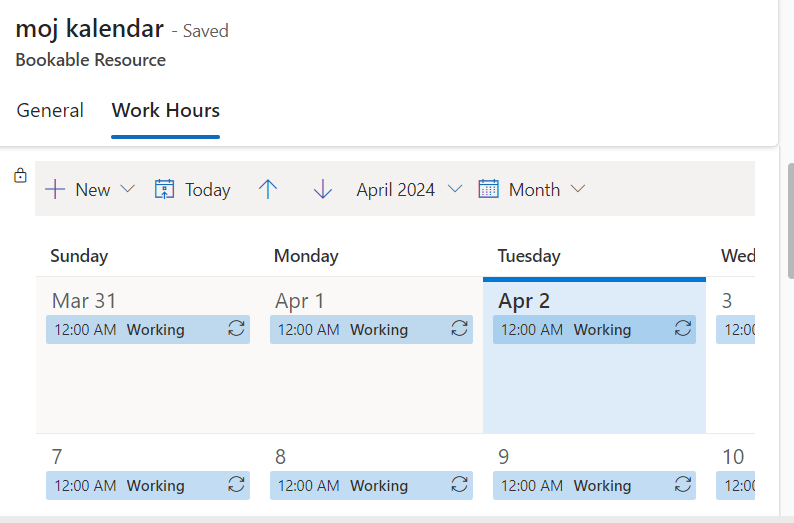

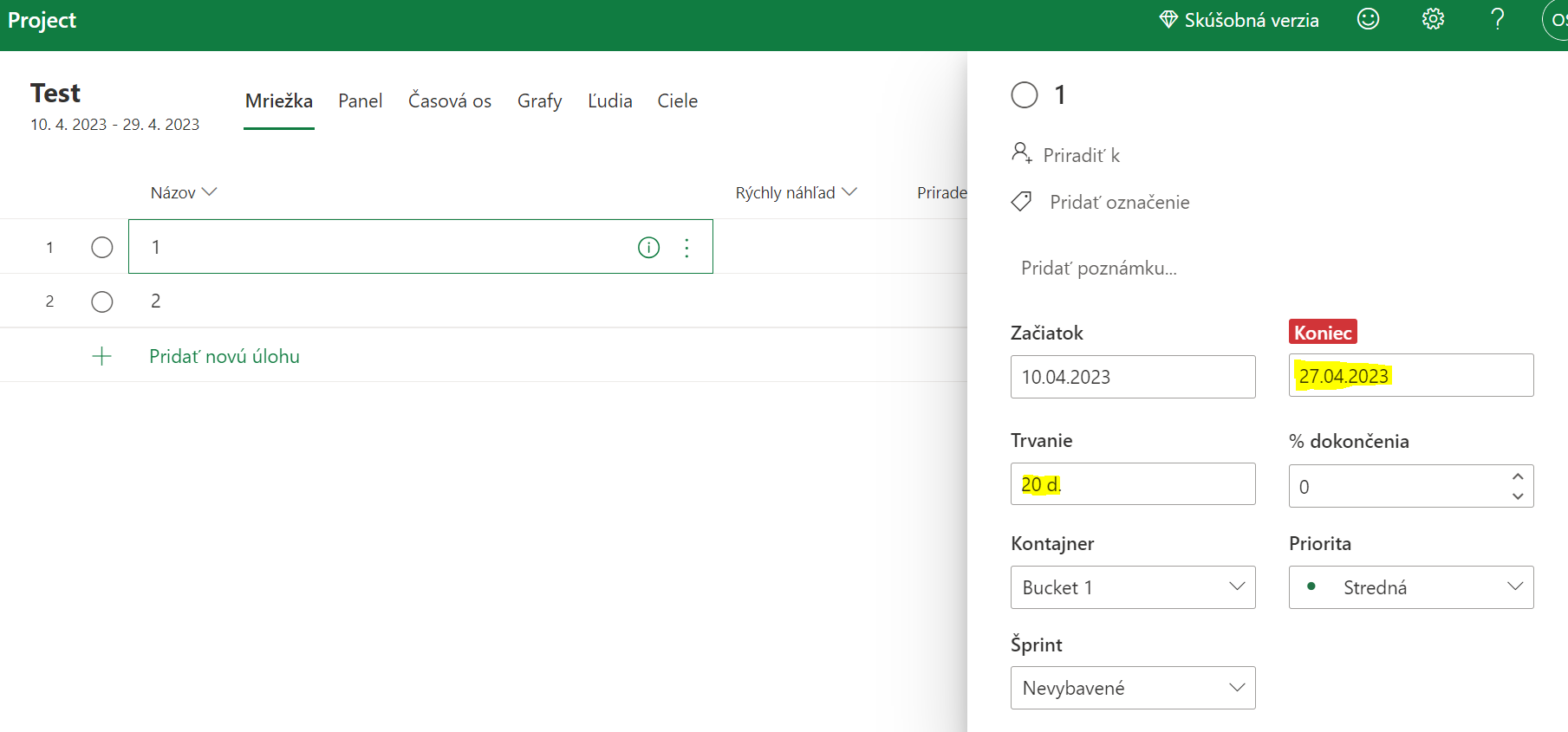

tasks.PNG calendar 1.PNG Calendar 2.PNG Calendar 3.PNG Calendar 4.PNG

At the same time when I try to create a new empty project, it writes me this message, I don't know if I messed up some settings.

"The session has expired. To continue, refresh the page view.Correlation ID: 83640c8a-12cc-4564-9275-39b6a36a148e"

Can you please help me with these 2 problems?

Thanks
