Share via

MS Project "Status Date" data

Anonymous
2018-08-10T15:03:46+00:00

Hello everyone,

I was reading up on the "Status Date" feature and I was wondering if I can use this to see historical data for my MS project files. For example, let's say I have a task called that has scheduled work of 40 hours and is due in 5 days. Let's say that I update my actual work daily and it looks something like this

Day 1 Actual work : 5hrs

Day 2 Actual work : 11hrs

Day 3 Actual work : 17hrs

Day 4 Actual work : 28hrs

Day 5 Actual work : 40hrs

After a week of the project being over, can I put the date of Day 3 in the "status day" and see that the actual work was updated to 17 that day? I have tried this but it doesn't seem to work however I saw a video that said that the "status day" should update all the columns in project as they were.

Thank you

Microsoft 365 and Office | Access | For home | Windows

Locked Question. This question was migrated from the Microsoft Support Community. You can vote on whether it's helpful, but you can't add comments or replies or follow the question.

0 comments No comments

Answer accepted by question author

John Project 49,710 Reputation points Volunteer Moderator
2018-08-10T15:22:30+00:00

PeterPeter_1963,

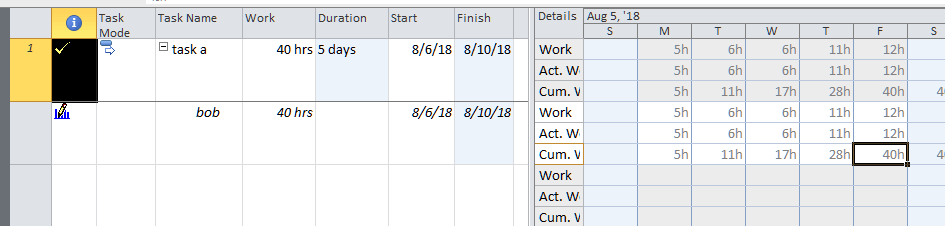

I have a better suggestion. Take a look at either the Task Usage or Resource Usage view and add Actual work and Cumulative Work to the Details for the timescaled data (right side of view). With the timescale set for days, you will be able to see the total cumulative work on any given day (see screen shot)

John

Was this answer helpful?

2 people found this answer helpful.
0 comments No comments

6 additional answers

Sort by: Most helpful
  1. Anonymous
    2018-08-10T21:03:42+00:00

    Perhaps the "desired data" is the 8 hours each day of baseline work.

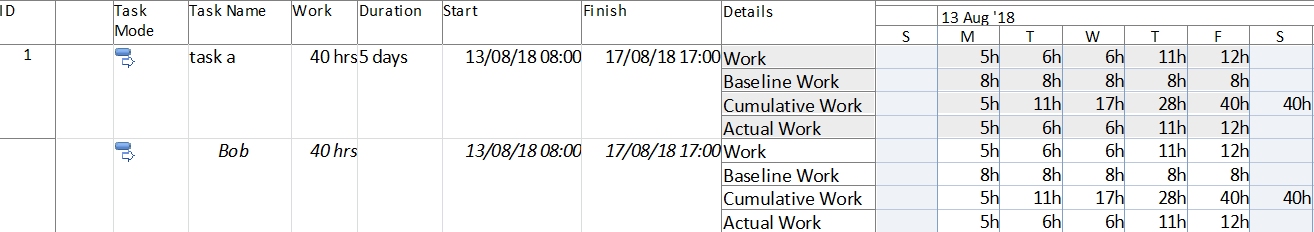

    Status Date is Friday 17:00 (or any date/time after that).

    By the way, if you adjust the timescale to hours, with both the task and the resource having the standard calendar, on the last day, Friday, your man Bob has done 1.5 hours of work for every hour of duration (and 1.38 hours on the Thursday). Model worker!

    Was this answer helpful?

    0 comments No comments
  2. John Project 49,710 Reputation points Volunteer Moderator
    2018-08-10T17:16:54+00:00

    PeterPeter_1963,

    What exactly is the "desired data"?

    John

    Was this answer helpful?

    0 comments No comments
  3. Anonymous
    2018-08-10T16:45:32+00:00

    Follow up question, what happens if my scheduled work is 8hr for all 5 days, will it keep the desired data?

    Was this answer helpful?

    0 comments No comments
  4. Anonymous
    2018-08-10T16:35:29+00:00

    This is exactly what I was looking for, thank you very much!

    Was this answer helpful?

    0 comments No comments
