Microsoft project management software used to plan, manage, and communicate a project schedule and other information among workgroup members, project managers, and other stakeholders.
Austin Nastasi,

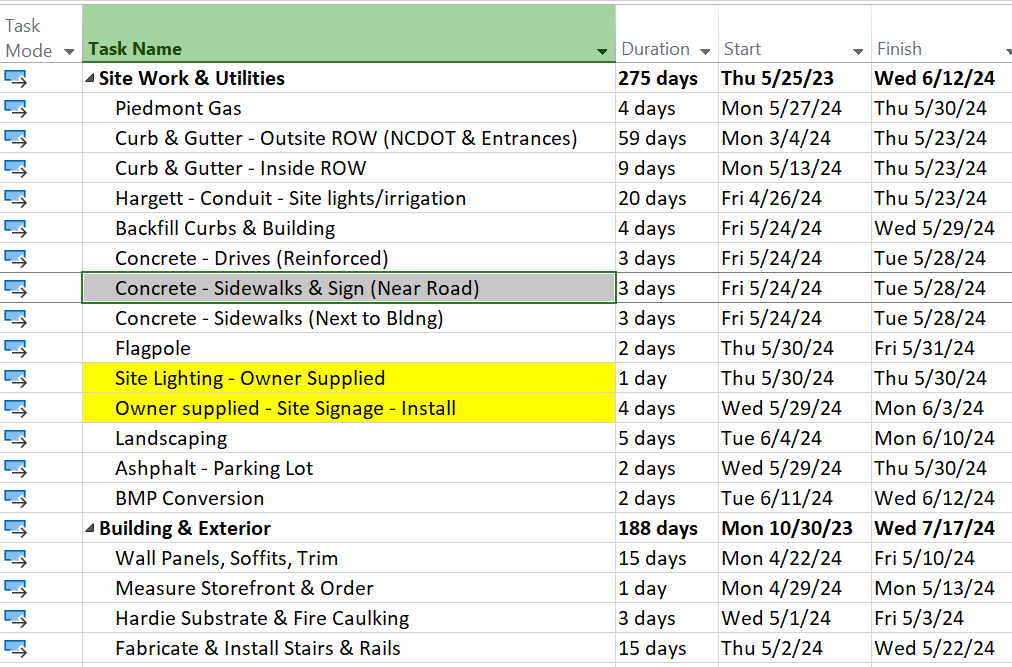

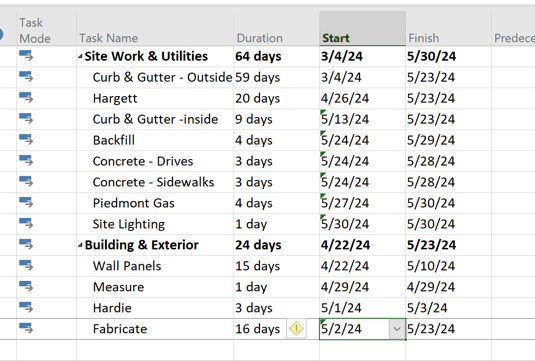

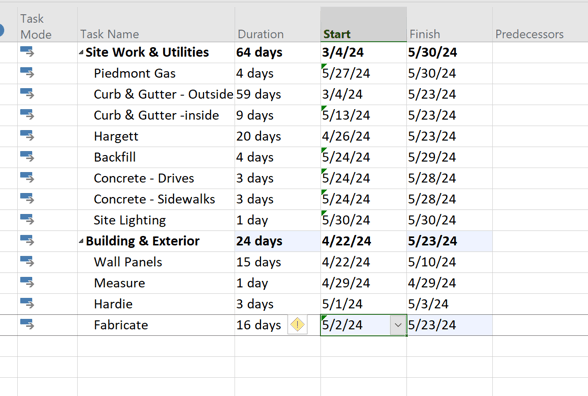

So it doesn't reorganize "everything", it sorts by start date and keeps the outline structure. But you want to take it a step further and keep the summary structure intact. Okay, can do. Add the Number1 field as a column in the view. Then set the number sequence of the summary groups (e.g. 1 for "Site Work & Utilities", 2 for "Building & Exterior" and so forth). Leave all performance tasks as "0". Now sort by Number1 and then by Start, keeping the option checked to "keep outline structure"
Does that work for ya?
John
