Set up roles on Work breakdown structure templates
Project managers can set up Work breakdown structure (WBS) templates that they can apply when they create a WBS for new projects. Project managers can add roles when they create a template. Use the following procedure to assign a role to a WBS template.
- Select Project management and accounting > Setup > Projects > Work breakdown structure templates.
- Select Details for a selected WBS template.
- Select a task in the list, and then, in the Role field, select a role to assign to the task.
Work with a WBS
You can create a new WBS, or you can copy a WBS from an existing WBS template. A project manager can easily manage the resources by assigning roles to new tasks on the WBS. Roles can be replaced either after a resource is acquired or after a confirmed resource to work on the task is identified. This flexibility lets project managers perform the following tasks:
- Identify the number of resources that are required for WBS work packages.
- Estimate project costs.
- Determine a preliminary budget.
- Estimate activity duration, based on roles and resources.
- Develop some project management plans, based on the available project information.
Additional options have been added in the WBS to better use the resourcing functionality.
Option | Description |
---|---|
Resource assignments | View the assigned resources, dates, number of hours, and booking type for tasks on the WBS. |
Auto generate team | Automatically add planned resources by using roles that are associated with a task. Finance automatically suggests planned resources by using multi-criteria decision analysis that is based on roles. After the roles and effort (hours) have been set for the tasks in a WBS, and after the structure has been released, select Auto generate team. The required number of planned resources is added to the WBS and the Project and team scheduling tab. |
Resource (drop-down list) | On the Launch resource assignment page, you can select resources to hard-book or soft-book, based on the specified duration. You can adjust the view settings to see and set the duration of resource activities. You can select and assign resources at the work package level by using the following options:
|
On the All projects page, select the XYZ Upgrade Phase 2 project.
Select Plan > Activities > Work breakdown structure.
Select New to add the following level-one activities to the WBS:
- Initiating
- Planning
- Executing
- Monitoring and Control
- Close

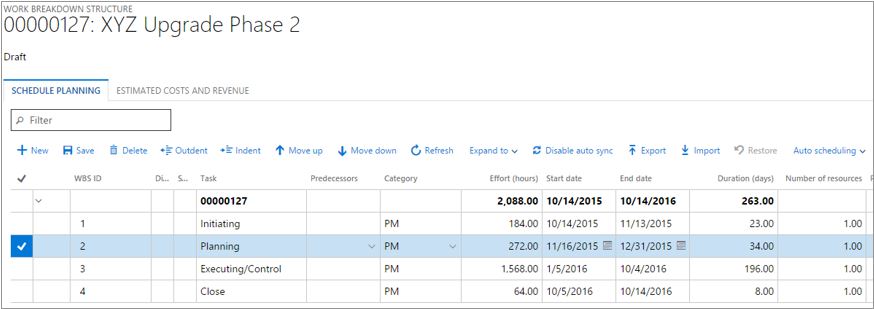

Set the dates and effort (hours), as shown in the following illustration.
Select the Initiating task line, and then, in the Role field, select Senior Project Manager.
Select Publish.
On the same line, in the Resource field, select Daniel Goldschmidt, and then select Accept.
Select the Planning task line, and then, in the Role field, select Business analyst.
Select Publish, and then select Auto generate team.
In the message box that appears, select Yes.
In the Resource field, verify that the value is Business analyst 1.
For the Business analyst 1 resource, open the lookup, and select Launch resource assignments. Then select a worker for the task.
Select Soft assign > Full capacity.
Note
You don't receive a warning that the specified resource is now 2, because the number of resources remains 1.
On the Work breakdown structure page, validate the resource assignment on the WBS, and then select Save.
